Caution | Outdoor water restrictions in effect

Stage 4 Outdoor Water Restrictions and the need for a reduction in indoor water use take effect August 26 at 12:01 a.m. Until that time, Stage 1 Outdoor Water Restrictions remain in effect.

Learn more

Bridgeland Main Streets

Phase 2 – 1 Avenue N.E.

Project update - August 2024

This construction season, as part of the Bridgeland Main Street Project, The City is completing sidewalk and streetscape improvements along 1 Avenue N.E. from 11 Street to 7A Street N.E.

Ongoing work – starting the week of August 5

  • Location: South side of 1 Avenue, between 7A to 8A Street N.E.
  • Timeline: Starting the week of August 5 for approximately eight (8) weeks
  • What:
    • Starting the week of August 5, we will be completing sidewalk and streetscape improvements on the south side of 1 Avenue N.E. between 7A to 8A Street N.E. (two street blocks), and we anticipate this work to take approximately eight (8) weeks.
    • Please note that in late August, construction may potentially also begin on an additional two street blocks at the north side of 1 Avenue N.E. between 6 to 7 Streets N.E. (for a total of four street blocks along 1 Avenue N.E. during this stage), and we anticipate this work to take approximately eight (8) weeks. Updates will be posted online.
    • Minor sidewalk reconstruction along 2 Avenue at intersections between 6 Street to 10 Street N.E. will continue concurrently and last throughout the year which is expected to have minimal effect to traffic access through the community.

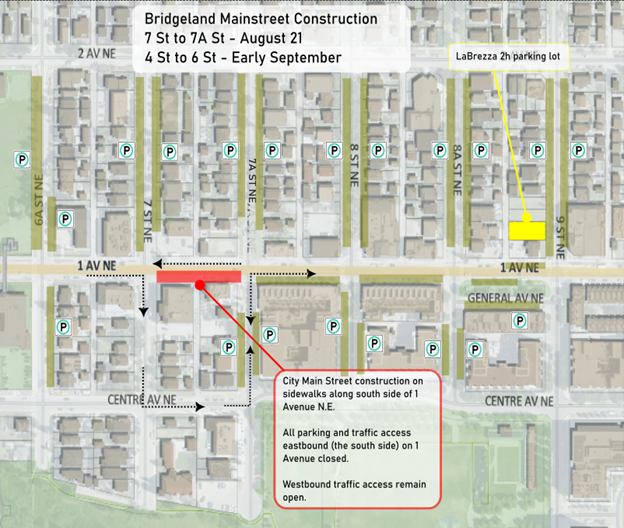

  • See the work areas and detour plans for 1 Avenue N.E.

Electrical Utility Crossing Installations (Spring/Summer):

The following streets near 1 Avenue N.E. will see one-day closures to complete important electrical utility crossing installations over the coming summer weeks:

  • 6 Street South side, August 17
  • 6A Street South side, August 18

We recognize that construction and community changes can be challenging. We want to thank you for your patience while we complete this important work.

Recently completed work

Crews recently finished sidewalk and streetscape improvements in the following areas:

  • South side of 1 Avenue (between 8A to 9A Street N.E.)
  • 1 Avenue N.E. (between 9A Street to 11 Street N.E.)

Check out some pictures below:

Work locations and construction impacts

Below you will see the coming sections of work.

Location Construction Scope Impact Anticipated Schedule* Status More Information
2 Avenue at intersections between 6 Street to 10 Street N.E.
  • Minor sidewalk reconstruction
  • Minimum impacts to traffic access
  • Please watch for crews and signage
Spring-Fall 2024 In progress
Various locations near 1 Avenue N.E.
  • Electrical Utility Crossing Installations
  • Road closure at intersection
  • Roadway cutting, utility installation in roadway.
  • Heavy machinery operating in the area
  • Noise

Spring/Summer 2024 In progress – started June 15, 2024
South side of 1 Avenue N.E. between 8A to 9A Streets N.E.
  • Phase 2 work
  • Pedestrian crossing & curb repair
  • Lighting upgrade
  • Tree planting
  • Street furniture install
  • Temporary relocation of transit stop, Canada Post mailbox and parking pay machine, as required
  • Heavy machinery operating in the area
  • Noise
June 24 - August Complete
South side of 1 Avenue between 7A to 8A Street N.E.
  • Phase 3 work
  • Pedestrian crossing & curb repair
  • Lighting upgrade
  • Tree planting
  • Street furniture install

  • Lane restrictions (one-way vehicular traffic detour)
  • Temporary relocation of transit stop, Canada Post mailbox and parking pay machine, as required
  • Heavy machinery operating in the area
  • Noise
Week of August 5 start (approximately 8 weeks of construction) Ongoing
North side of 1 Ave. N.E. from 11 St. N.E. to 9A St. N.E.
  • Widened sidewalks
  • Phase 1 work
  • Pedestrian crossing & curb repair
  • Lighting upgrade
  • Tree planting
  • Street furniture install
  • Lane restrictions (one-way vehicular traffic detour)
  • Temporary relocation of transit stop, Canada Post mailbox and parking pay machine, as required
  • Heavy machinery operating in the area
  • Noise

April 21 start (approximately 8 weeks of construction)

Complete

Contact us

Do you have a specific question about the Bridgeland Main Street Construction project? Send us an email:
bridgelandmainstreet@calgary.ca

Stay connected

Sign up for our email updates to receive ongoing updates about the Bridgeland Street Main Street construction project.

We’re piloting something new to support businesses!

The City has launched a new pilot to test financial support for businesses during planned Main Streets construction. The Main Streets Business Support Grant pilot provides a one-time lump sum payment of $5,000 to eligible businesses affected by planned 2024 City-led construction of Main Streets projects, including Bridgeland.

Parking

Businesses remain open throughout the construction period! Navigate your way through Bridgeland by walking, cycling, or using other transportation options, following the designated construction detour signage. Refer to the map below to find convenient parking locations during construction.

Stage 3 Parking – Starting the week of August 5, 2024

Bridgeland parking map - Stage 3 starting August 5, 2024
Click to enlarge map

* Please note: the anticipated schedule is subject to change depending on factors such as complexity, weather, supply chain, and access.

upcoming-item

Category Icon and Label

Live

2025

Start Date | End Date

  • Ongoing investment in development
  • Operations and maintenance

current-item

Category Icon and Label

Build

2022 – 2025

Start Date | End Date

  • Phase 1 (Edmonton Trail) 2022-2023
  • Phase 2 (1 Ave. N.E.) 2023-2025
  • Construction of designs based on streetscape master plan

past-item

Category Icon and Label

Design

2018 – 2021

Start Date | End Date

  • Pedestrian safety measures implemented
  • Detailed design work complete
  • Community engagement
  • Bridgeland Streetscape Master Plan completed and approved

past-item

Category Icon and Label

Plan

2017

Start Date | End Date

  • Land use redesignation and infrastructure assessment

past-item

Category Icon and Label

Strategize

2014 – 2016

Start Date | End Date

  • Public engagement and market studies

What to expect through Construction on 1 Avenue and 2 Avenue N.E.

What you can expect during construction:

  • Sidewalk closures and detours ensure pedestrians and cyclists can travel safely through the area and still access their destinations.
  • We will work directly with individual businesses to minimize the impacts of construction and provide continued access to their property as much as possible.
  • The temporary closure of some parking, roads, and potential road detours. Traffic will be maintained during construction, by way of local detours.
  • Temporary relocation of transit stops, Canada Post mailboxes, and/or Calgary Parking Authority pay machines.
  • An increase in on-site construction activity, including construction crews, vehicles and heavy equipment, and an increase in noise and vibration throughout construction.

2024-2025 construction areas along 1 Avenue N.E.

The second phase of the project will see operational and streetscape improvements along 1 Avenue N.E. from 4 Street N.E. to 11 Street N.E., and along 2 Avenue N.E. between 6 Street N.E. to 10 Street N.E.  and is expected to be in construction until Fall 2025.

The map below shows the 2024-2025 construction areas along 1 Avenue N.E.

Schedule subject to change as required to meet project requirements

Click to enlarge map

Project scope

The 1 Avenue N.E. Main Street underwent the “design” step of the Main Streets program in 2018 and 2019. Based on community feedback, technical analysis, and financial considerations, we created a plan to support the needs identified by the community.

Phase Two of the Bridgeland Main Street project involves operational and streetscape improvements along 1 Avenue N.E. from 4 Street to 11 Street, and along 2 Avenue N.E. between 6 Street N.E. to 10 Street N.E.

Work includes:

  • Widened sidewalks.
  • More plants and trees.
  • New street lighting along the road and sidewalks.
  • New crosswalks with wheelchair ramps complete with tactile plates to help those with vision loss at intersections.
  • Additional/upgraded pedestrian crossing signals at several intersections. Changes to intersection controls on 2 Avenue N.E.
  • New waste & recycling bins, bike racks and benches.

Please see the Roll Plot for more detailed information:

  • 4 Street N.E. to 6A Street N.E.
  • 6A Street N.E. to 8A Street N.E.
  • 8A Street to 11 Street N.E.

What is planned for Bridgeland Main Street Phase 2: 1 and 2 Avenues N.E.?

The 1 Avenue Main Street vision encompasses numerous considerations, including:

  • A focus on urban design and placemaking.
  • Enhanced pedestrian safety and comfort.
  • Improved mobility options, including transit and cycling
  • A design that is uniquely “Bridgeland-Riverside” and reflects its heritage and community identity.
  • Improved connections to park spaces and amenities.
  • Enhancing the community’s Main Street as a destination that will support existing and new local businesses.

A rendering of what 1 Avenue may look like:

Click to enlarge map

The proposed plans for 2 Avenue N.E. include the adjustment of the intersection controls and new stop signs.

Click to enlarge map

Project documents

Project background

The City developed a Streetscape Master Plan for Bridgeland based on citizen feedback, technical analysis, and financial considerations.

The vision for the Bridgeland Main Streets project is to build a streetscape that includes well-designed, quality public realm elements and public space, that prioritize the pedestrian experience and will support ongoing redevelopment and a thriving economic environment. Once complete, it will offer a variety of safe, accessible mobility connections, new community gathering spaces, and a uniquely Bridgeland character.

The key features of Bridgeland Main Streets are:

  1. Prioritize pedestrian safety
  2. Enhanced landscaping for pedestrian comfort
  3. Unique streetscape elements
  4. New opportunities for community gathering
  5. Improved mobility options

Past engagement: 1 Avenue N.E.

Main Streets


The Main Streets Program is one of the ways that the City of Calgary is working to make our city “a great place to make a living, and a great place to make a life.” Our program shares The City’s common purpose of “making life better every day” by implementing a comprehensive process to transform our main streets into places where people want to live, work and play.

To reach their full potential, Calgary’s Main Streets need both public and private investment. The Main Streets program is a continuum that goes from changes to land use that will support development opportunities to a streetscape master plan that is designed to support these changes and can be constructed in a coordinated fashion. The increase in development activity will bring more people and new jobs to the community, making the area more attractive to local businesses and residents.

Core values

Main Streets are resilient, adaptable, and attractive places that support:

  • Character & Identity
    Create a street that establishes a unique sense of place and offers memorable experiences for both residents and visitors.
  • Social & Healthy lifestyle
    Create a family-friendly and safe street environment that focuses on promoting sense of community.
  • Mobility & Functionality
    Achieve a balance of multi-modal transportation options with a focus on friendly and inclusive design.
  • Economic vitality
    Street improvements promote economic vitality by encouraging redevelopment opportunities and promoting investment.

This information has no legal status and cannot be used as an official interpretation of the various bylaws, codes and regulations currently in effect. The City of Calgary accepts no responsibility to persons relying solely on this information. Web pages are updated periodically. ​

undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null
