Project Update - October 2, 2024

Until recently, the majority of work was happening overnight to account for lane closures so exterior work could be done, this has now changed to daytime work as window glazing for the bridge going over 6 Ave has been completed. Glazing for the second bridge going over the parking lot is ongoing.

Flooring and carpeting from both bridges have been removed, with structural reinforcement ongoing. Skylight replacement has begun and the fall arrest system install is happening. There are also various mechanical and electrical installs happening as well.

The construction timeline is still on schedule and being actively monitored to prevent delays to construction. Crews have been on site daily working from 6 A.M. to 3:30 P.M.

Please check back on this page for the closure start date and for updates throughout construction.

Project update – July 8, 2024

Two Plus 15 bridges and the podium connecting them will be closed for construction from August 6, 2024 to mid-December 2024. The bridges are located over 6 Avenue S.W. and over the parking lot on the north side of 6 Avenue, between 2 and 3 Street S.W.

Plus 15 businesses will be open during construction and detours will be in place during construction.

Please check back on this page for the closure start date and for updates throughout construction.

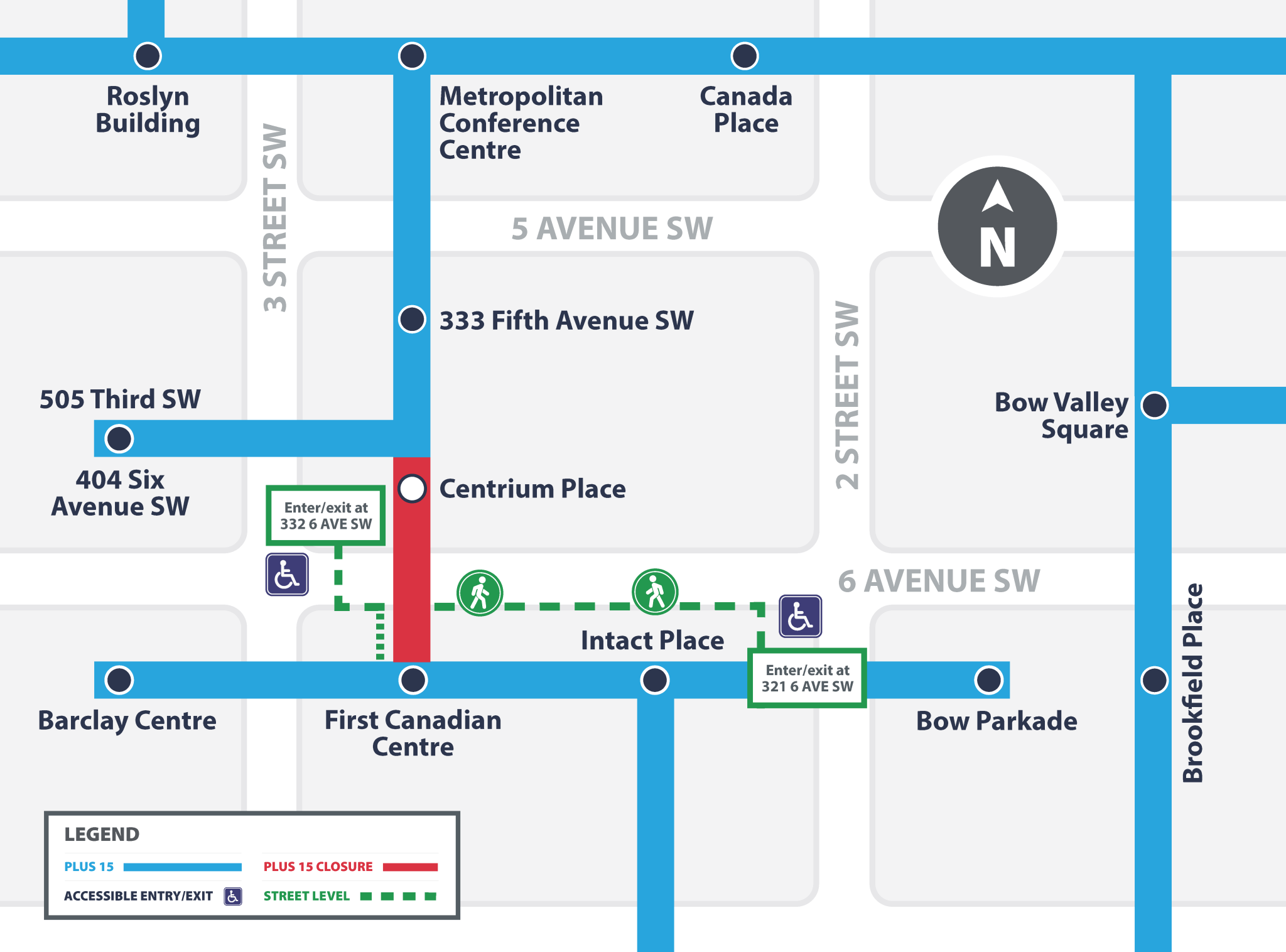

Plus 15 Detour map

Project overview

Two Plus 15 bridges and the podium connecting them will be closed for renovation work:

  • The first bridge connects First Canadian Centre to Centrium Place over 6 Avenue S.W.
  • The second bridge connects Centrium Place to 333 5 Avenue S.W. over the parking lot.
  • The podium connects the two bridges and Centrium Place, with access to street level.

Please note, the construction plan is still being finalized and the schedule is subject to change depending on factors including but not limited to existing conditions, weather, and supply issues.

Please check the map below for the location of these Plus 15 bridges:

Improvements to the Plus 15 bridges will include:

  • Replacement of roofing materials;
  • Glazing and skylights;
  • New fall arrest system;
  • New mechanical system and lighting fixtures; and
  • New interior finishes with accessibility improvements (including handrails, tactile flooring and automatic doors).

Stay connected

Have questions or concerns about the project? Email: plus15renovation@calgary.ca


Timelines

  • Contract Awarded: May 2024
  • Construction: August – mid-December 2024

Budget

The budget for this project is $3.27 million.


Related information

Frequently asked questions

Why is this project happening?

The Plus 15 infrastructure is aging and require renovations to ensure they remain safe and in good condition. These projects prolong the life of the Plus 15 structures so they can be used in years to come.

Will businesses in the Plus 15 Network be open during construction?

Businesses in the Plus 15 will be open during construction. Plus 15 users can access the businesses via the detours in the Plus 15 and street level. Detour signage will be provided on this page and in the Plus 15.

Why don’t I see any contractors working on the Plus 15 bridges?

The majority of the work is occurring after hours and at night due to noisy work and to reduce the impact to building tenants.

Why can’t you partially reopen the Plus 15 bridges?

Plus 15 bridge closures are required to protect public safety, as life safety systems are being upgraded and floors are being replaced or rebuilt. The bridges cannot be re-opened, whether fully or partially, without appropriate life safety systems in place.

They cannot be opened to the public until it has been inspected and approved for use.

When will this project be complete?

Major construction activity is expected to be complete by mid-December 2024.

undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null,undefined/null
