Nose Creek Sanitary Sewer Trunk
About the project
The Nose Creek Sanitary Sewer Trunk (NCSST) Project involves twinning the existing sanitary sewer trunk that runs from the Bow River, north beyond Beddington Trail N.E. This extension will more than double the sanitary sewer capacity which is required to accommodate future development and population growth in north Calgary.
Without this new infrastructure in place, forecasts suggest that the existing sanitary system would reach capacity in or around 2030. The project work began in 2008 and consists of three phases of work.
Project benefits
- This project work is necessary for storm and wastewater management and accommodates projected population growth in North Calgary.
- Much of this project work will be completed by tunnelling which reduces construction impacts on park and green space.
- We are improving Laycock Park for all users, including completing missing pathway connections and constructing a new parking lot. In addition, a rain garden will be planted with low-maintenance water-wise plants that attract birds, butterflies and mosquito-eating dragonflies.
Project status – January 2025
Upcoming construction:
- Sanitary sewer manhole installations and tunnelling shafts backfilling at sites A, B and C (listed on map below).
- Sanitary sewer manhole installation 800 metres south of Beddington Trail N.E. beside the Nose Creek Pathway in March 2025.
- Sanitary sewer pipe excavation installation north of Beddington Trail N.E along Deerfoot Trail.
- Remainder of the Laycock Park drainage improvements:
- Parking lot upgrade, rain garden installation and new pathway connection.
- Landscape restoration from April to September 2025.
- Anticipated construction completion - September 2025.
Completed construction:

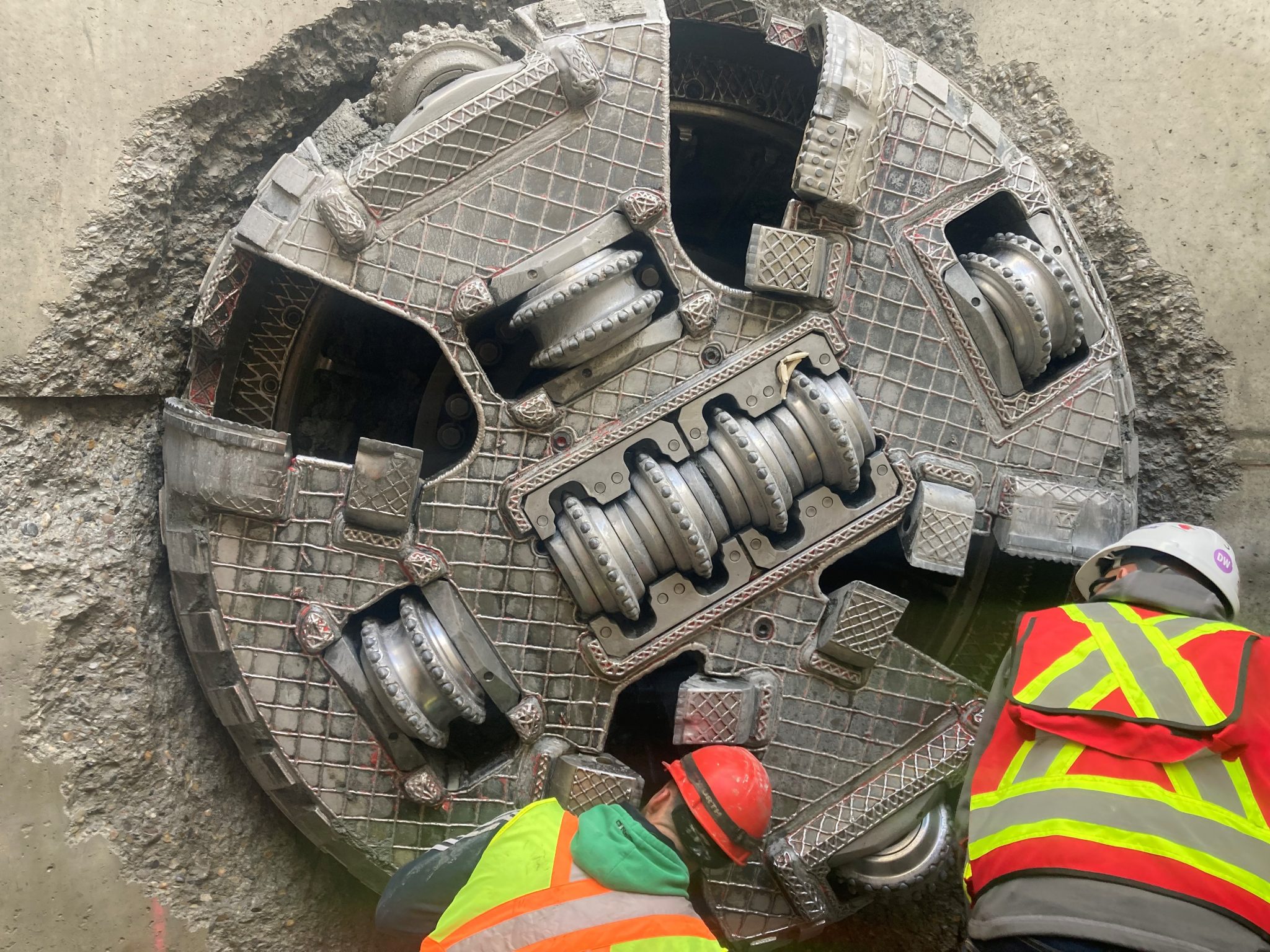

- Sanitary sewer pipe tunnelling from A to B and A to C (listed on map below).
- Portion of the Laycock Park drainage improvements:
- Oil-Grit Separator upgraded, erosion protection installed at the outfall and a pathway/access road to the outfall was paved.
Construction impacts
- Construction hours are:
- 7 a.m. to 10 p.m. Monday to Saturday
- 9 a.m. to 10 p.m. on Sunday
- Nose Creek Pathway delays south of Beddington Trail N.E. in March and April 2025.
- Laycock Parking lot closure from April to June 2025.
- Residents may notice an increase in construction noise.
- Residents may notice an increase in vibrations while crews are working, but we do not anticipate any impacts to private property.
- Park users may notice diesel odours where crews are working with large equipment.
- Residents and pedestrians are reminded to watch for detour signs and please obey all temporary speed limit reductions that may be in place. We also ask that drivers in the lane closest to a stopped roadside worker vehicle with its lights flashing move over to the far lane to give workers extra space, if possible.
- The contractor will take steps to limit the amount of dust and mud from the work area.
Construction timelines
- March 2024 – Q2 2025: Sanitary sewer pipe tunnelling. Construction sites for tunnelling shafts will be setup (A) south of Beddington Trail N.E. beside the Nose Creek Pathway, (B) in Laycock Park beside 64 Ave N.E., and (C) at the Beddington Trail N.E. and Deerfoot Trail interchange near Nose Creek.
- Q3 2024 – Q3 2025: Laycock Park drainage improvements located within the park on both sides of Nose Creek.
- Q1 2025 – Q3 2025: Sanitary sewer pipe excavation at Beddington Trail N.E. and Deerfoot Trail, east of Deerfoot Trail.
- Q2 2025 – Q3 2028: Landscape restoration scheduled at multiple locations, where required.
Project map
Click image to expand Download map
Detour maps
Laycock Park Access Rd detour map
Click image to expand Download map
Confluence Park Access Rd detour map
Click image to expand Download map
Hunstrom Rd NE detour map
Click image to expand Download map
Project timeline
Phase A - involved twinning the existing sanitary sewer trunk along Nose Creek from the Bow River to 32 Avenue NE. Construction work started in 2010 and was completed in 2013.
Phase B - involves twinning over 10km of sanitary pipe from 32 Avenue NE past Beddington Trail NE. Construction started in 2014 and work has been ongoing. Construction for the final segment of Phase B work will begin in 2024 and involves the installation of 2.2km of 1650mm sanitary pipe from south of 64 Avenue NE to north of Beddington Trail NE.
Phase C - transferred into a new project: Saddle Ridge Sanitary Sewer Trunk Upgrade. This project added a relief sanitary sewer trunk connection to the Nose Creek sanitary sewer trunk from Fox Hollow Golf Course, under Deerfoot Trail, and into the sanitary system near 11 Street NE and 12 Street NE, which services a large portion of northeast Calgary. The work was completed in 2017.
